ABOUT THE ENERGY PARK PROJECT
Tušimice – Process of formation
A 50 MW battery storage system with a capacity of 100 MWh is being built in Tušimice. An expansion to 200 MWh is already planned. From securing the project to construction on site: This timeline shows the development and the crucial milestones along the way to commissioning.
On this timeline, we document the most important milestones, the construction progress, and the delivery of the central components of our battery storage system.
Home " References " Tusimice
November 5

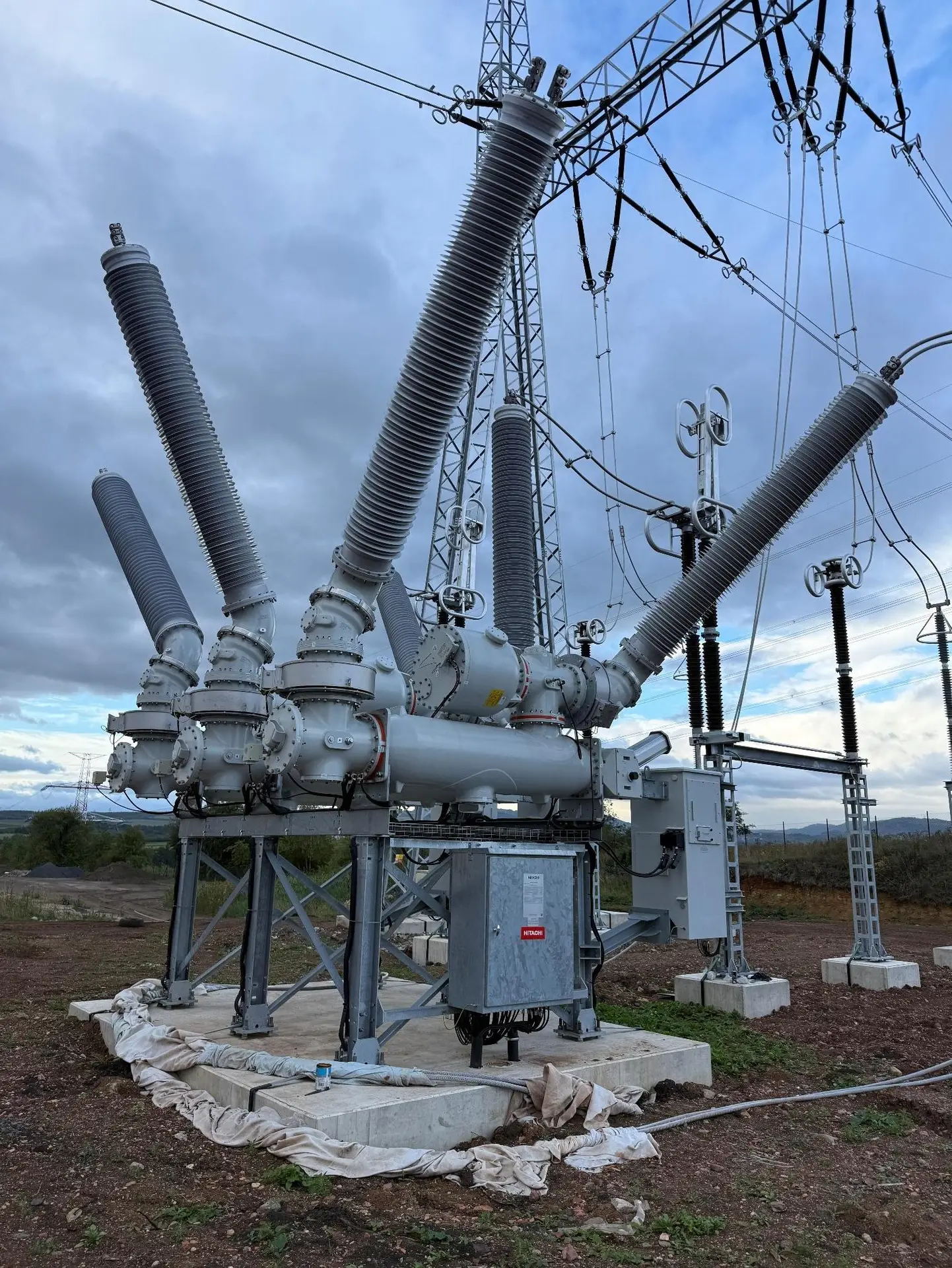

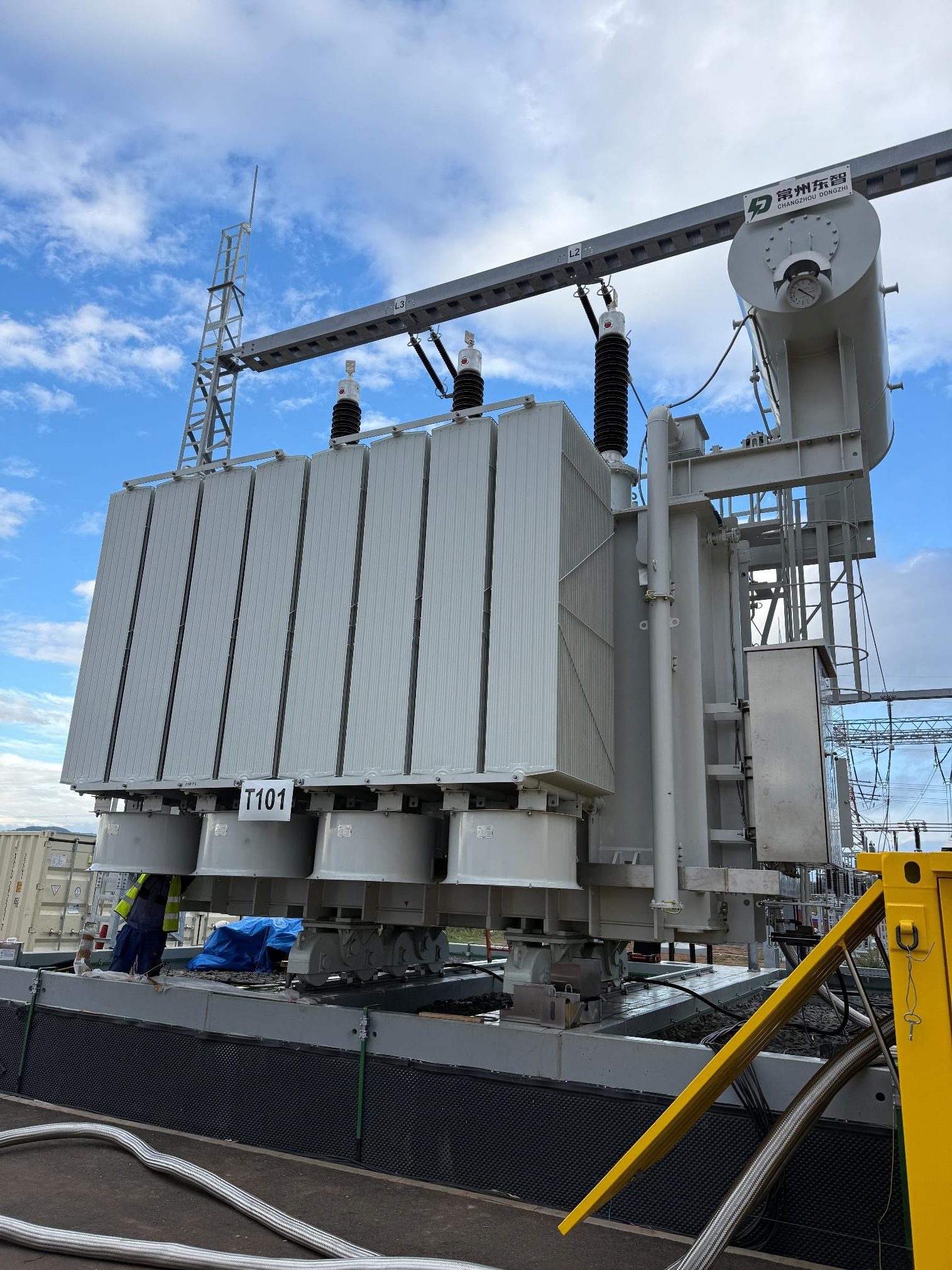

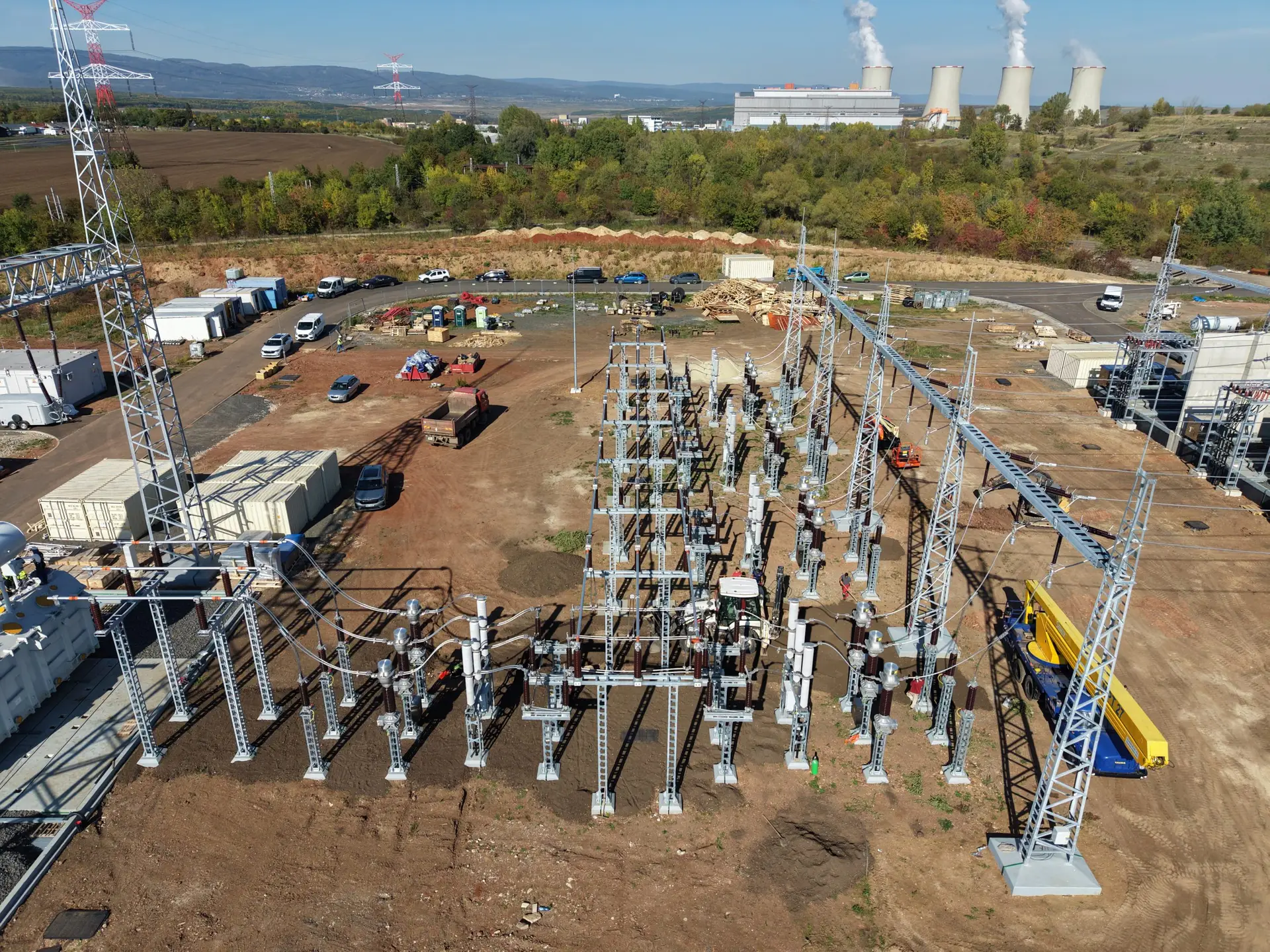

Power connection and commissioning of the transformer

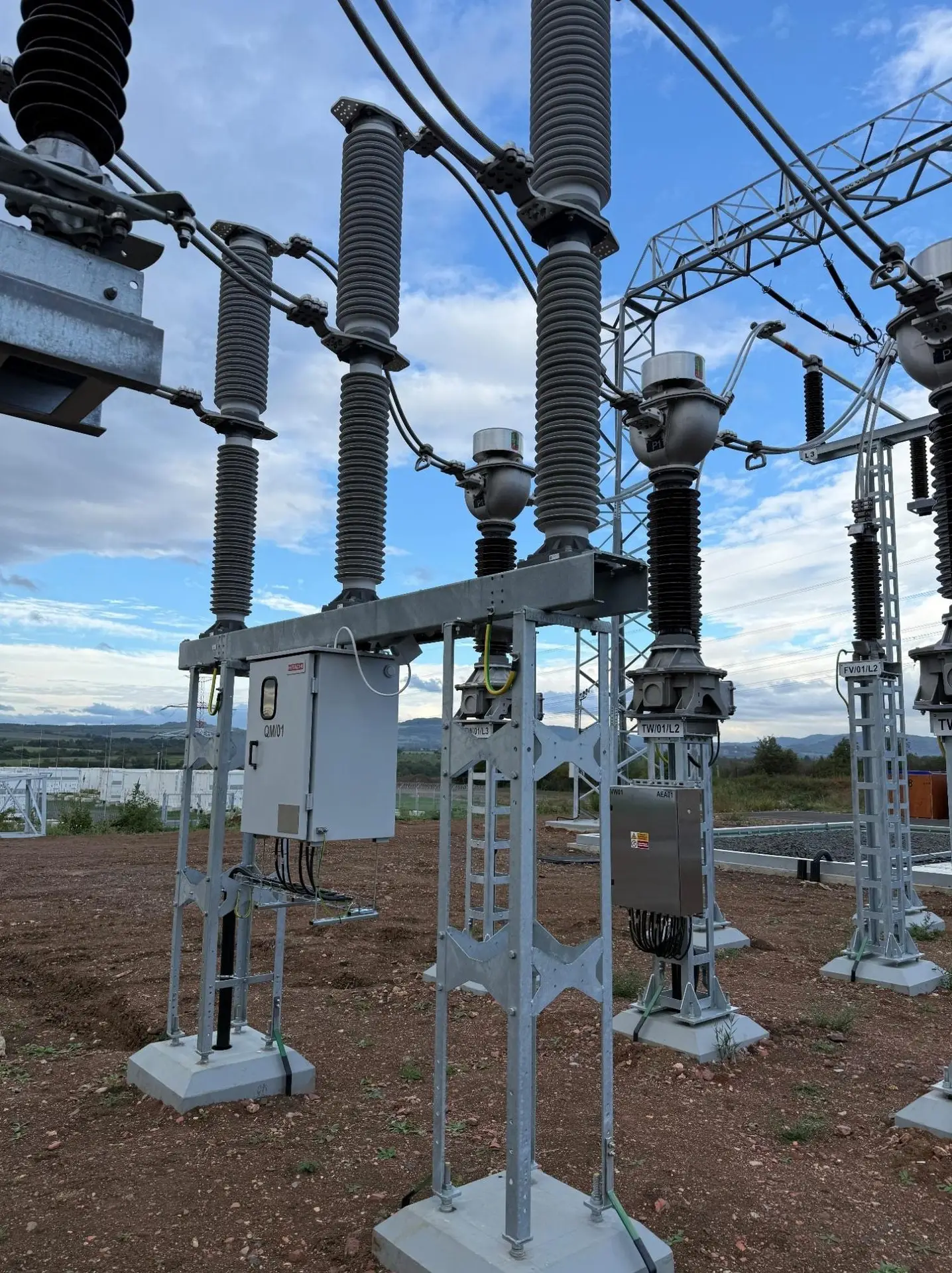

The transformer has been commissioned and successfully tested. The protection technology and communication systems are functioning as planned; the substation is now energized. This means that the Tušimice energy park is connected to the electricity grid.

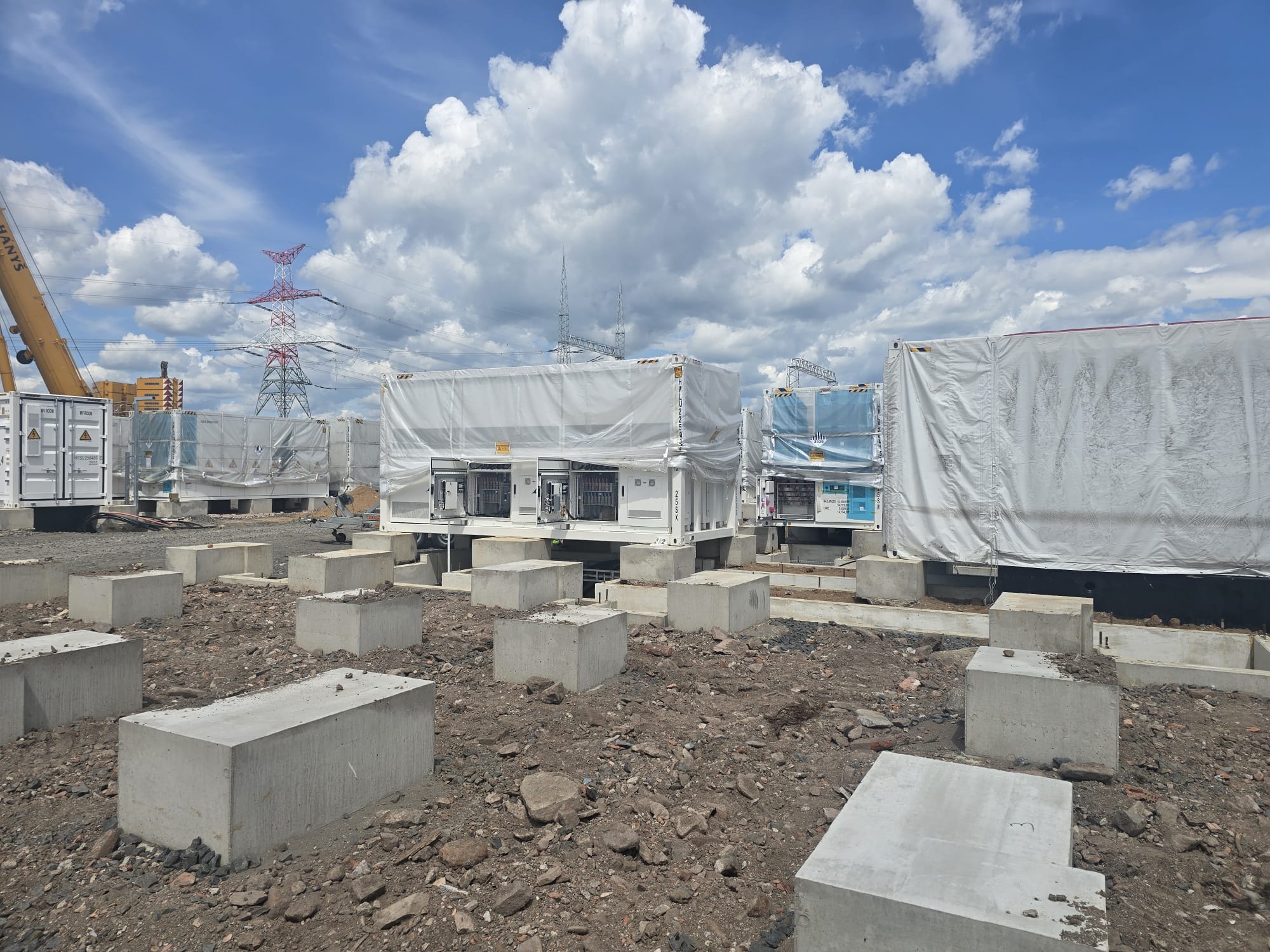

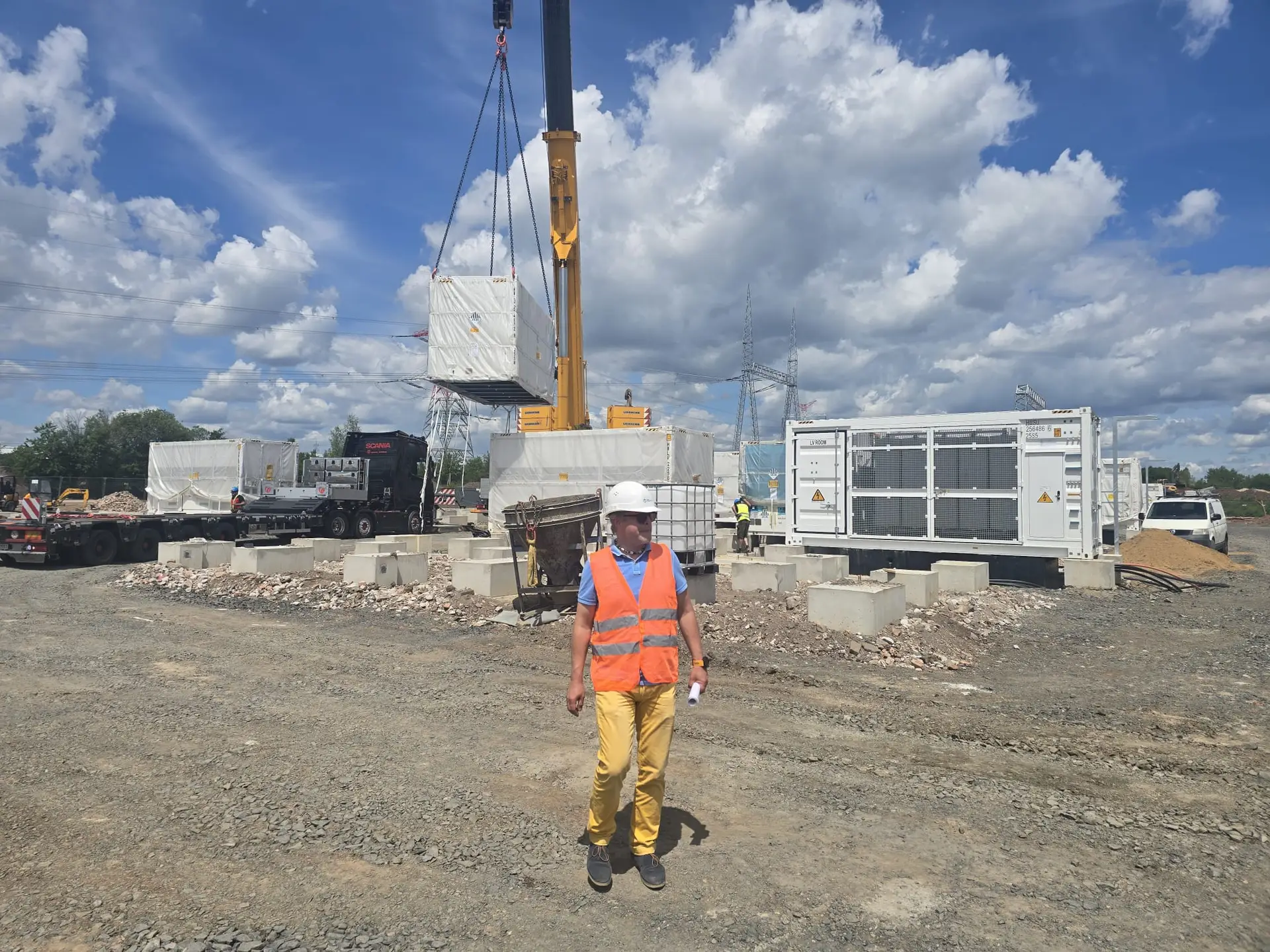

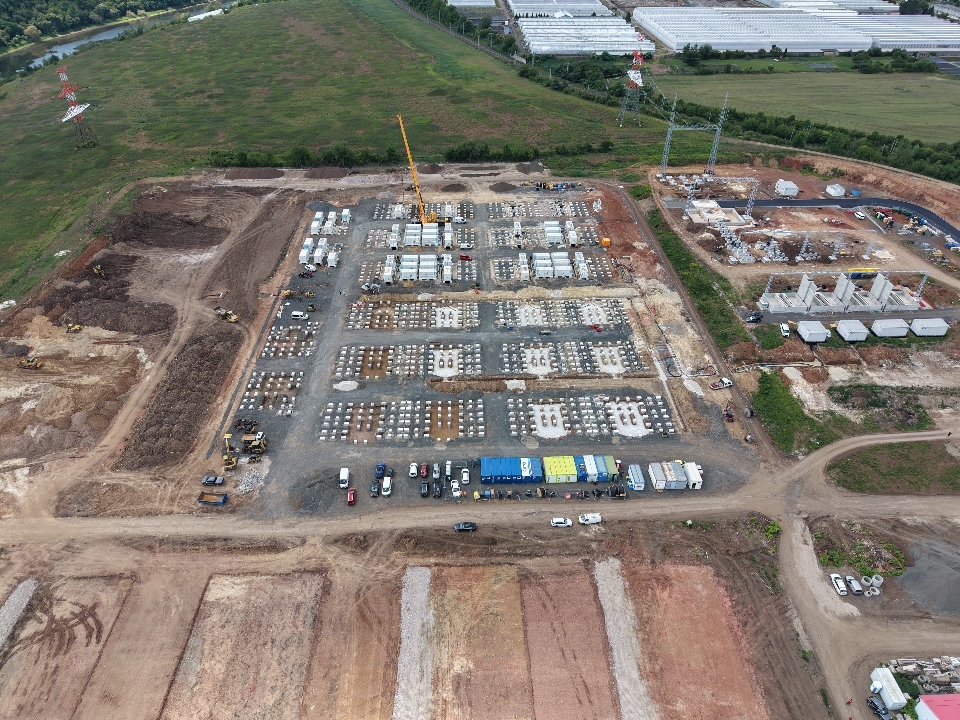

At the same time, the entire BESS park continues to take shape

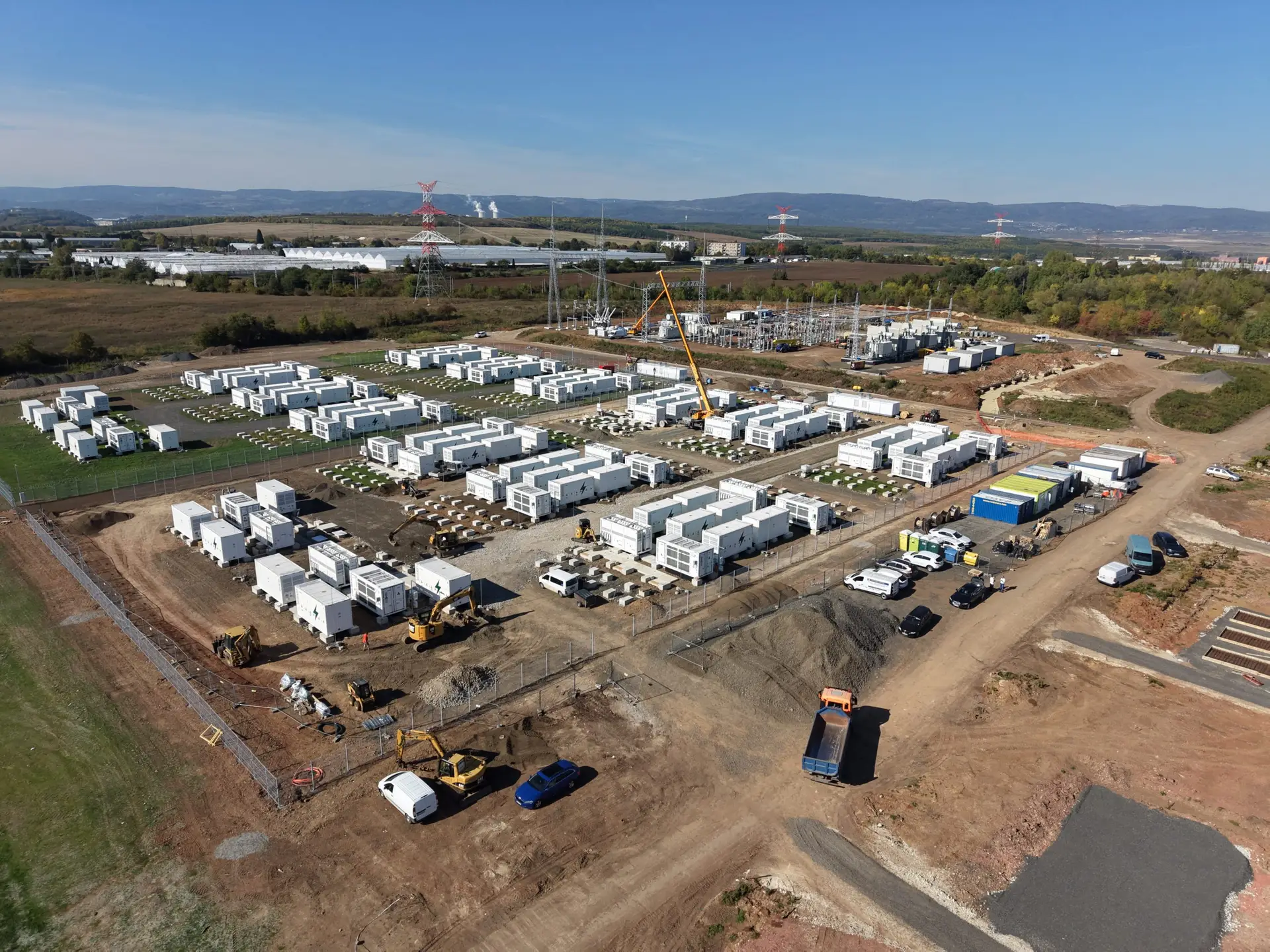

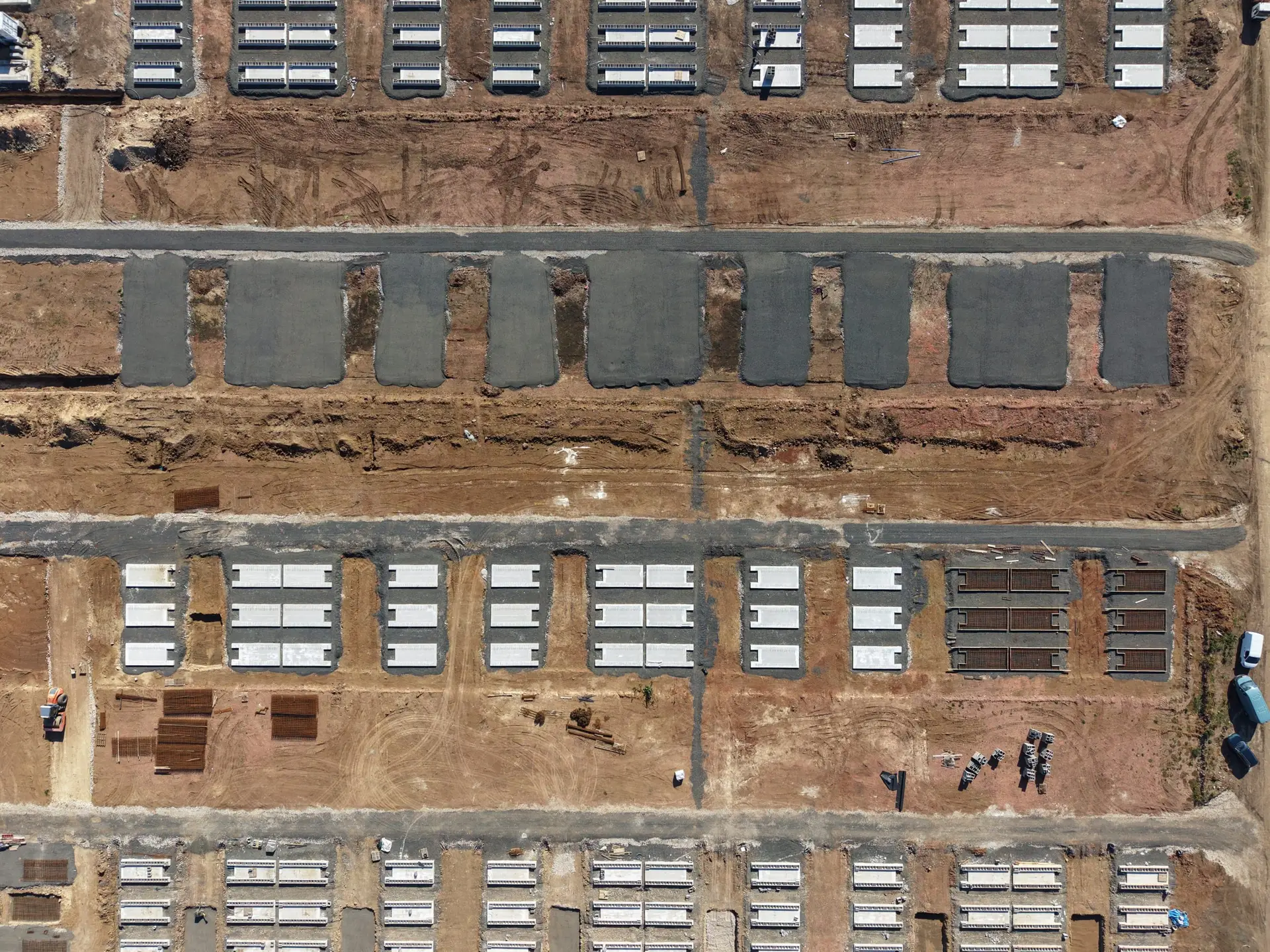

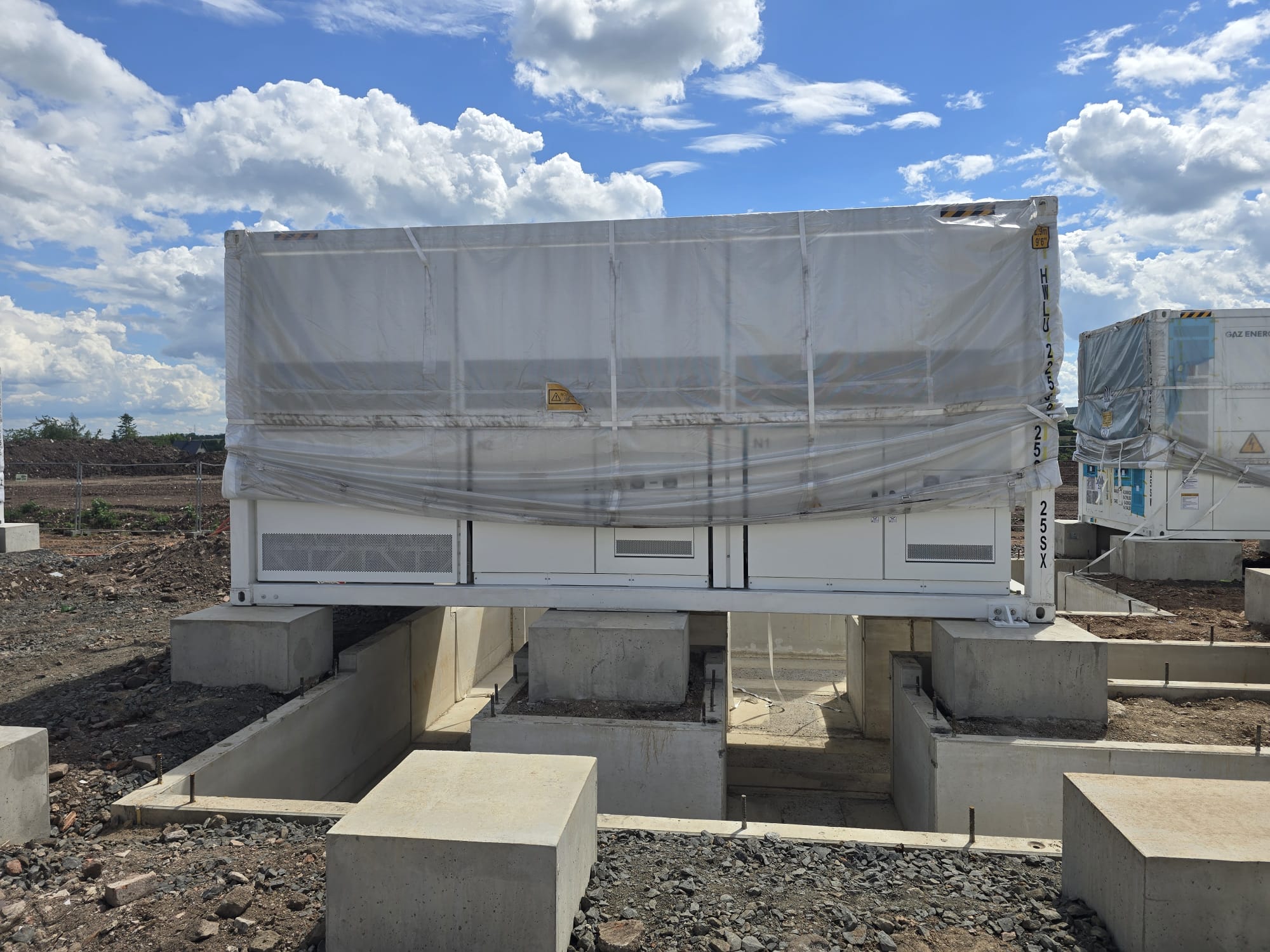

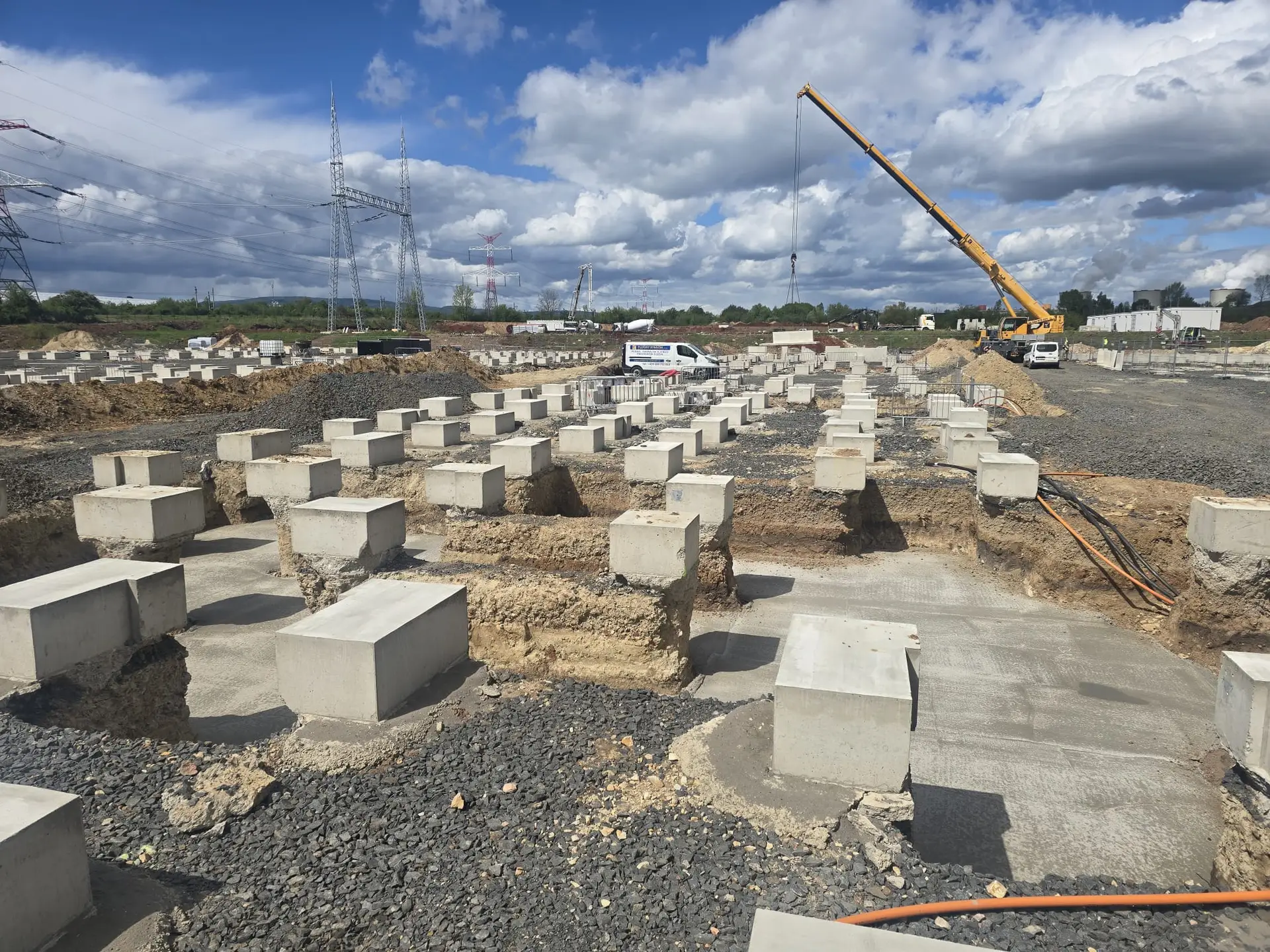

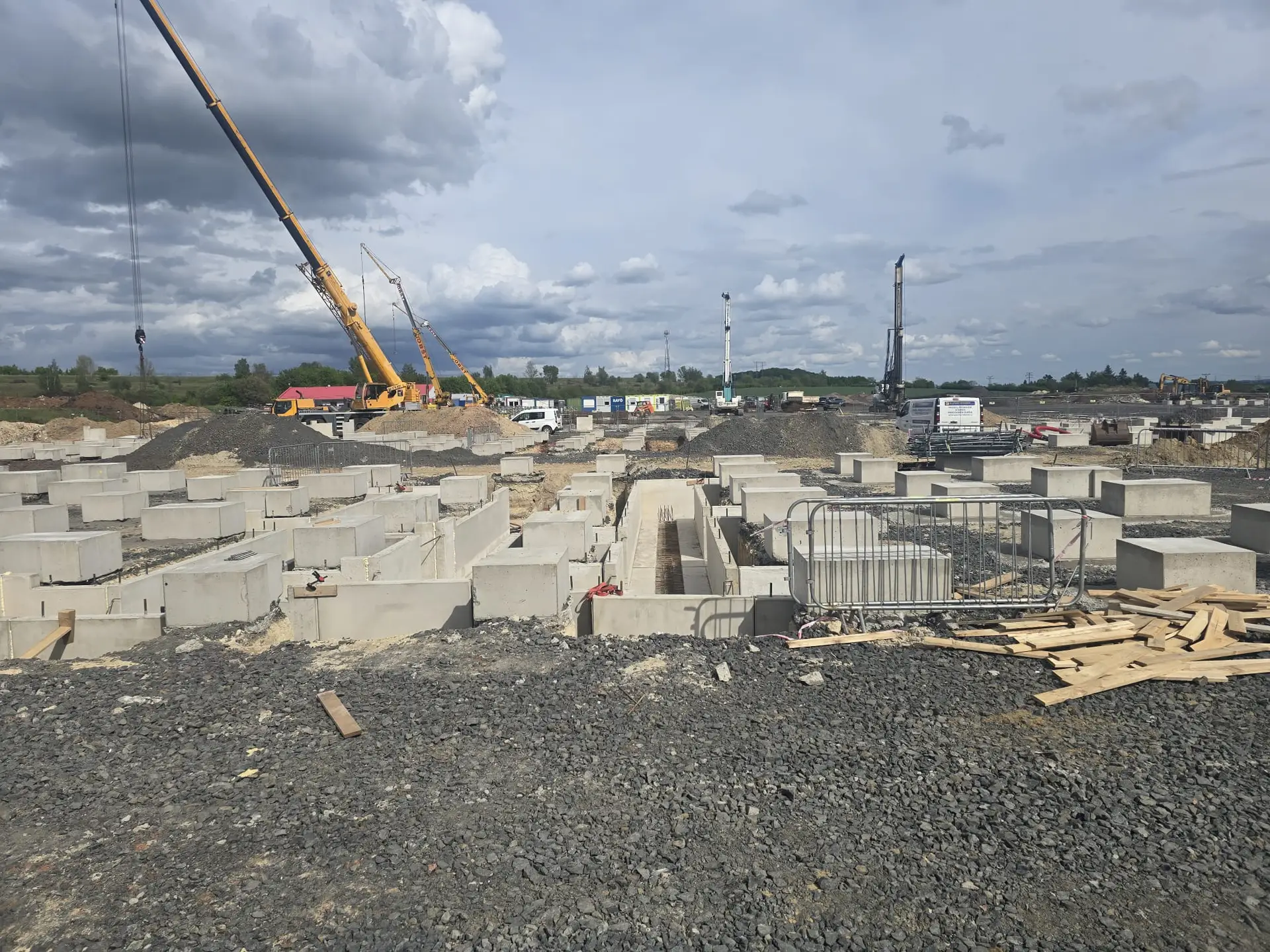

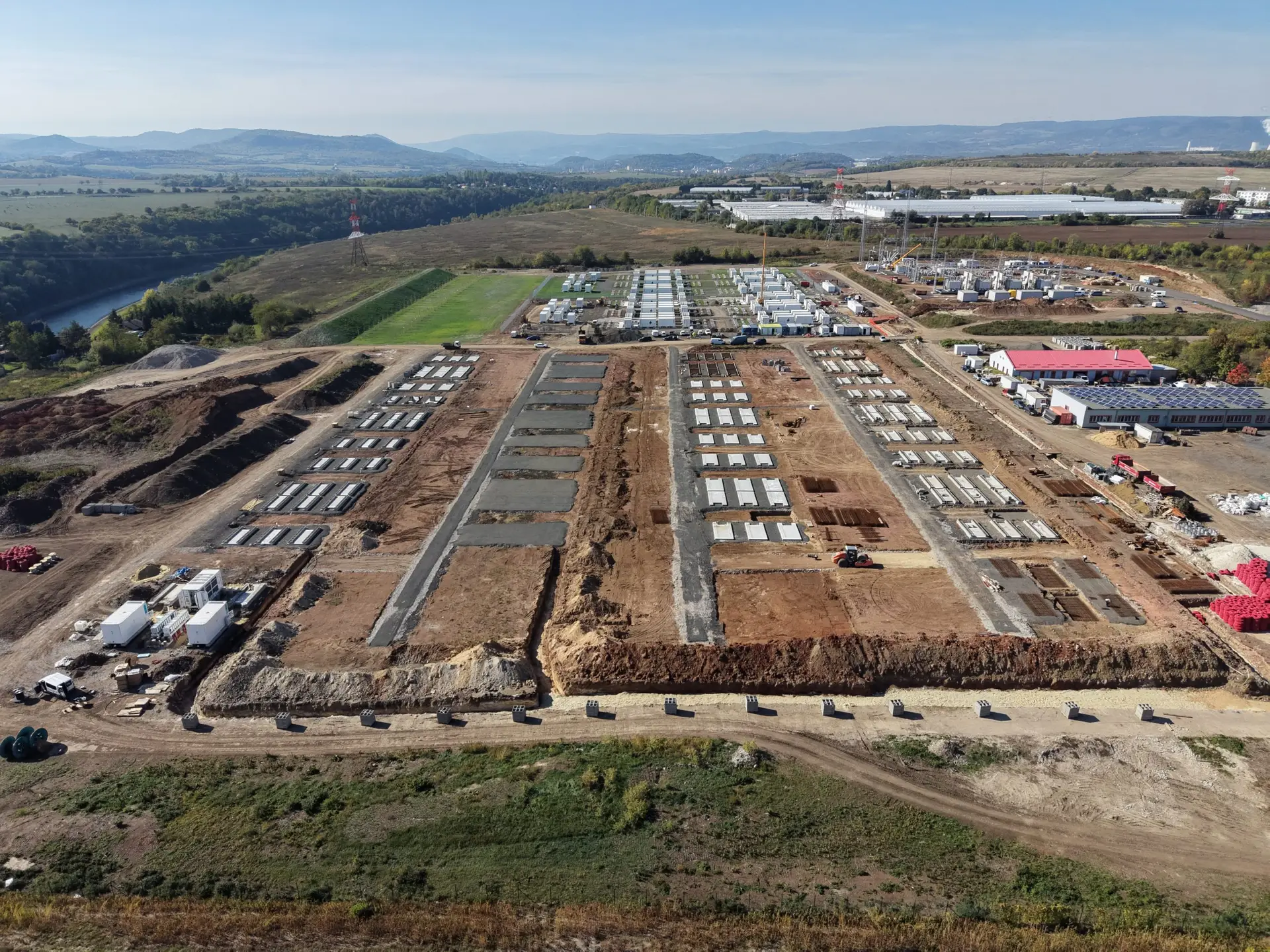

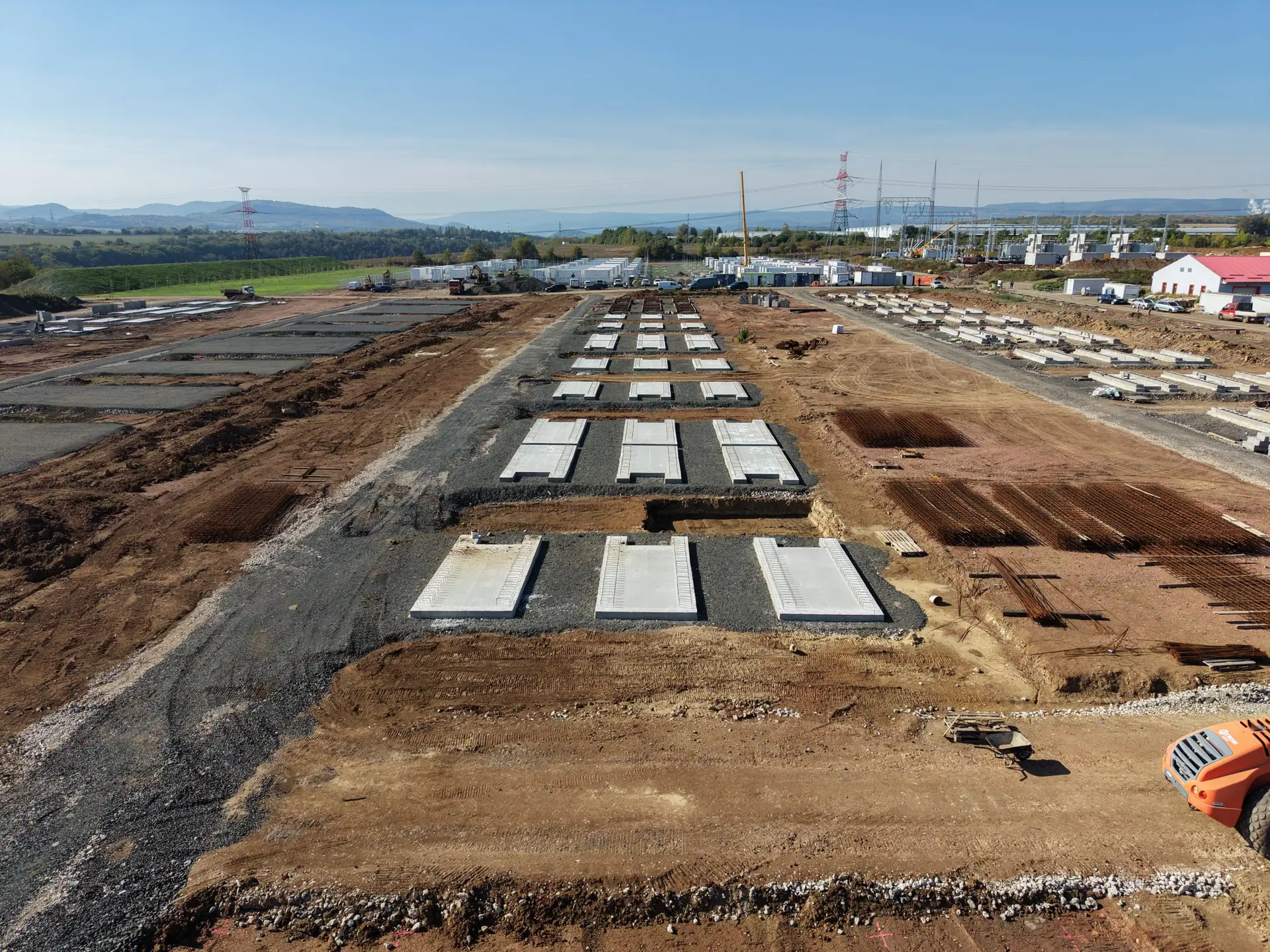

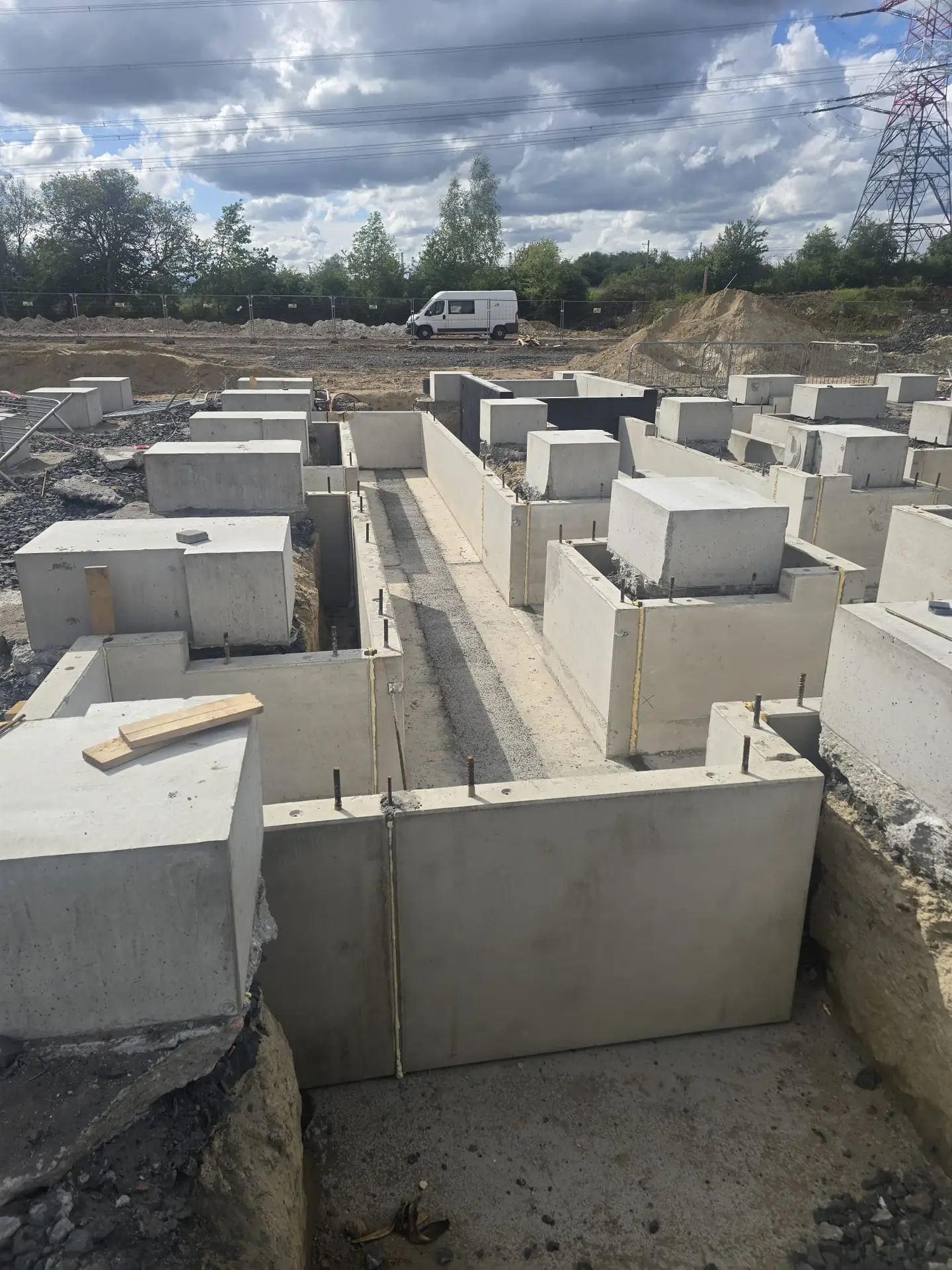

The first section of the battery storage park has been completed, and the next construction phases are underway on the adjacent plots of land.

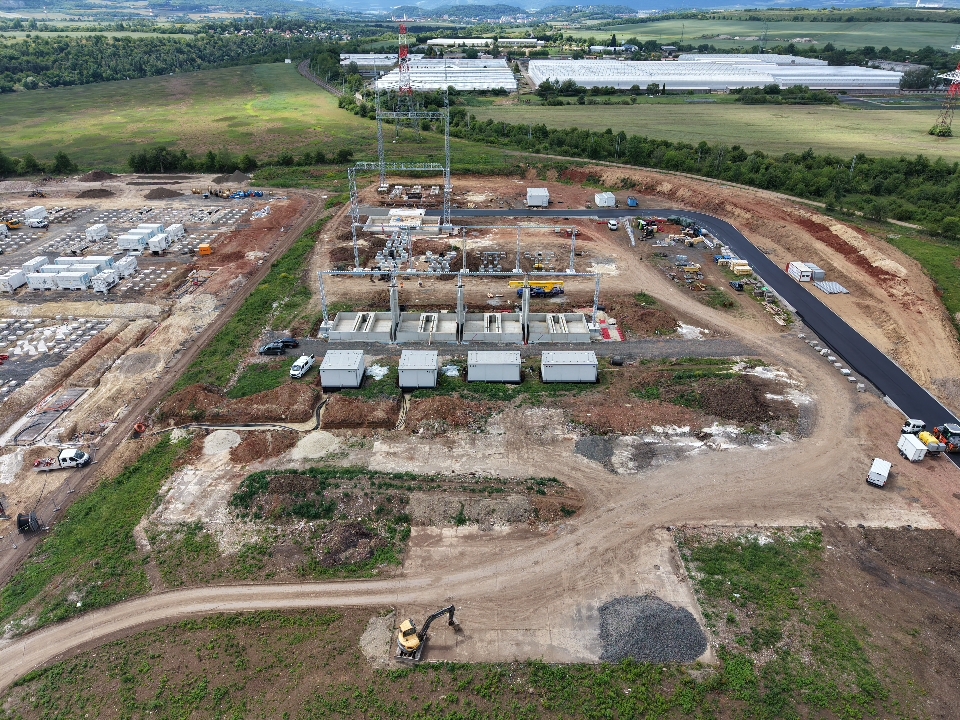

May 14th
May 4th

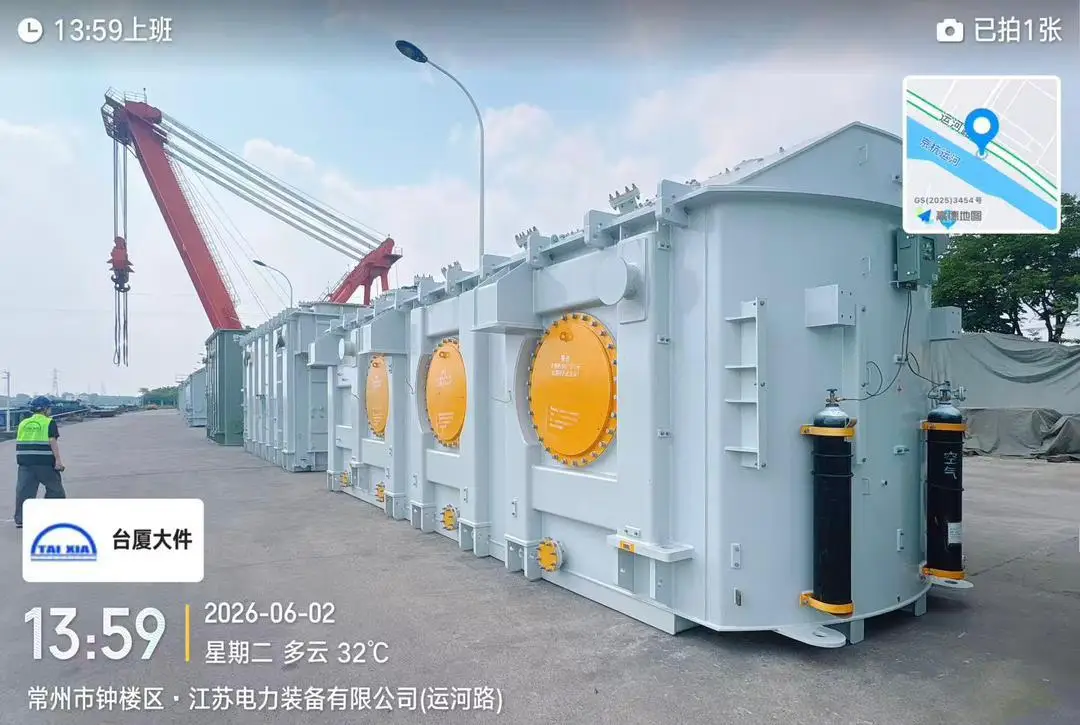

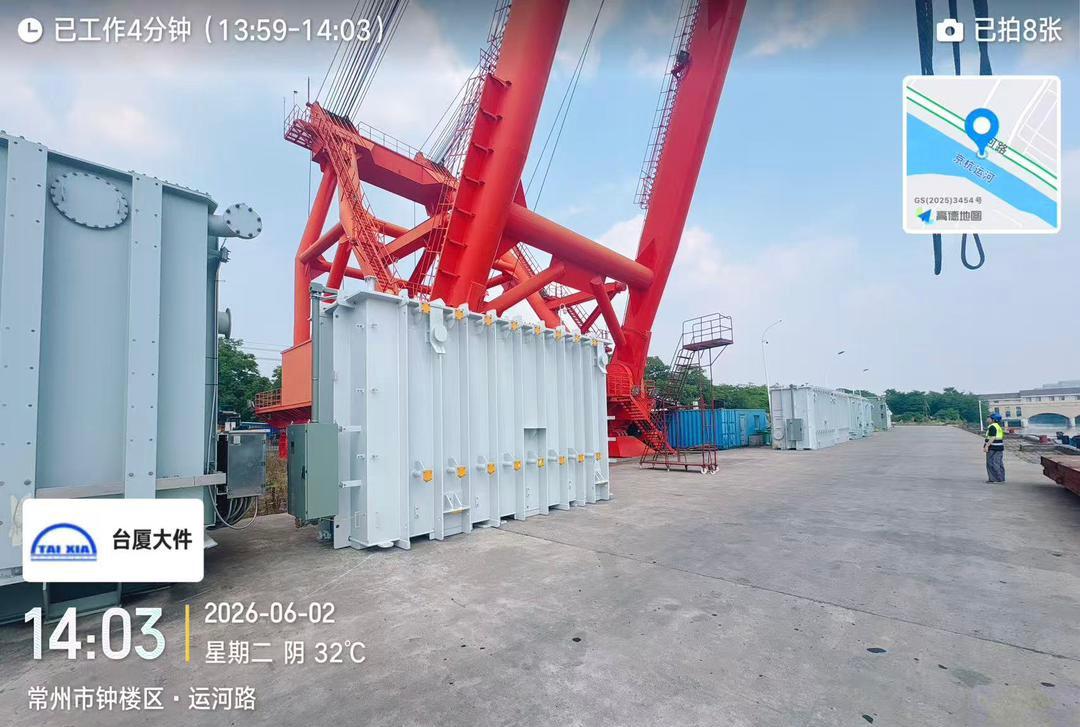

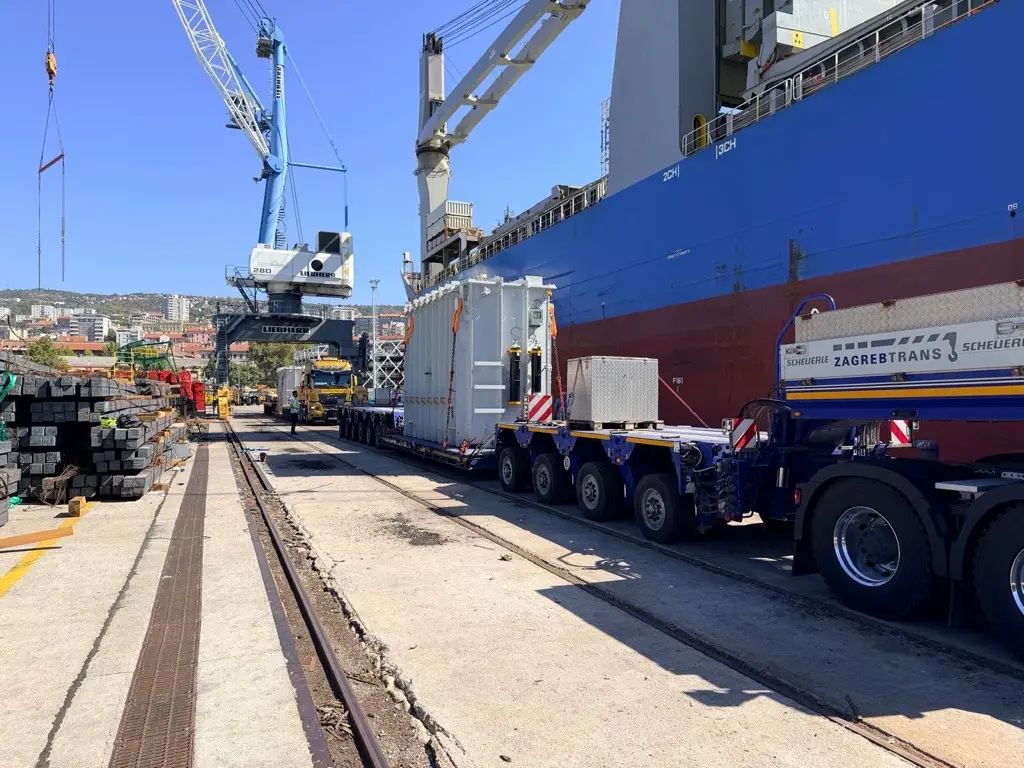

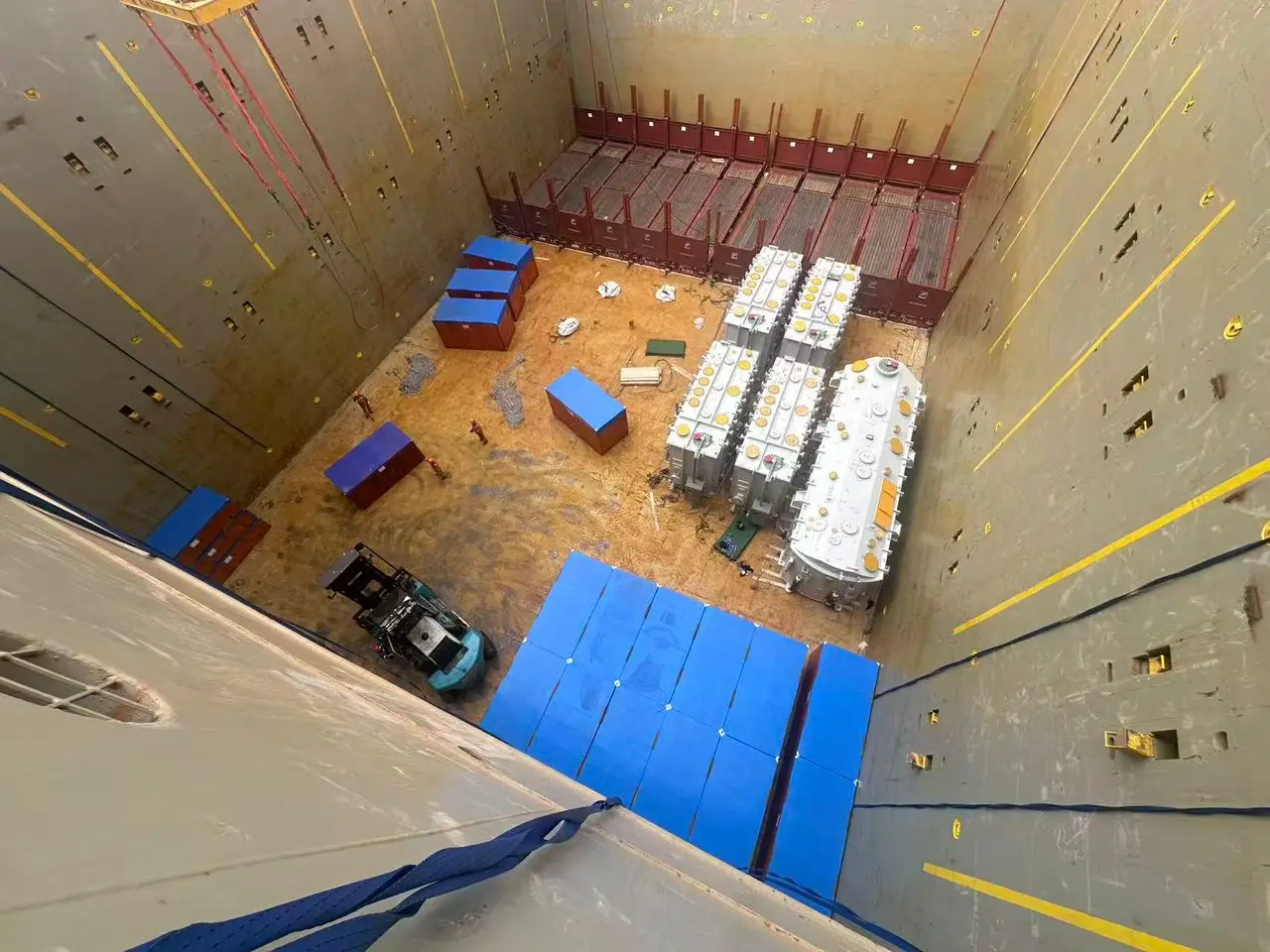

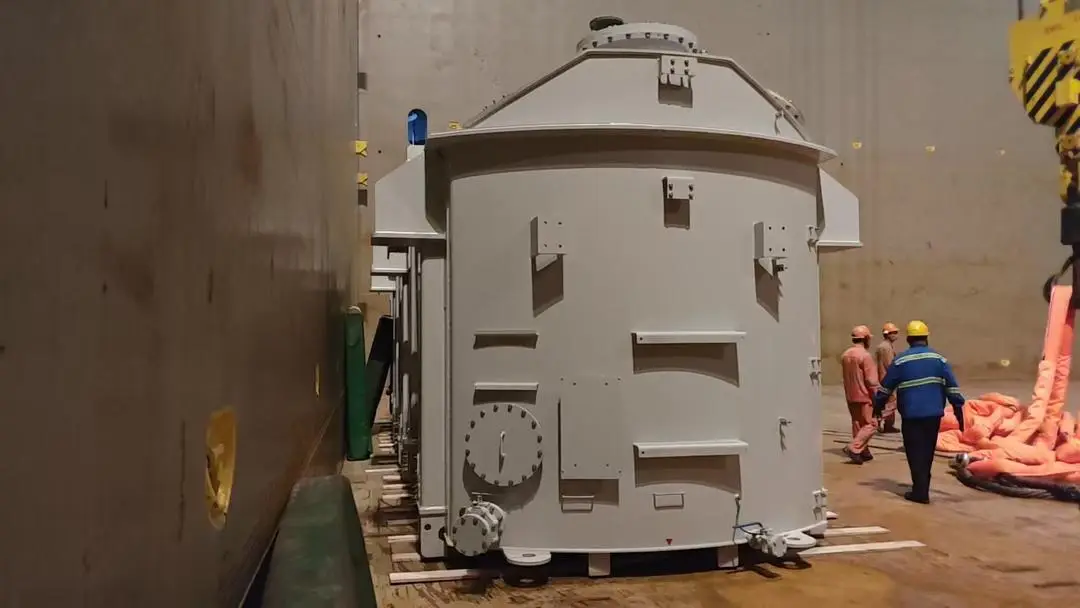

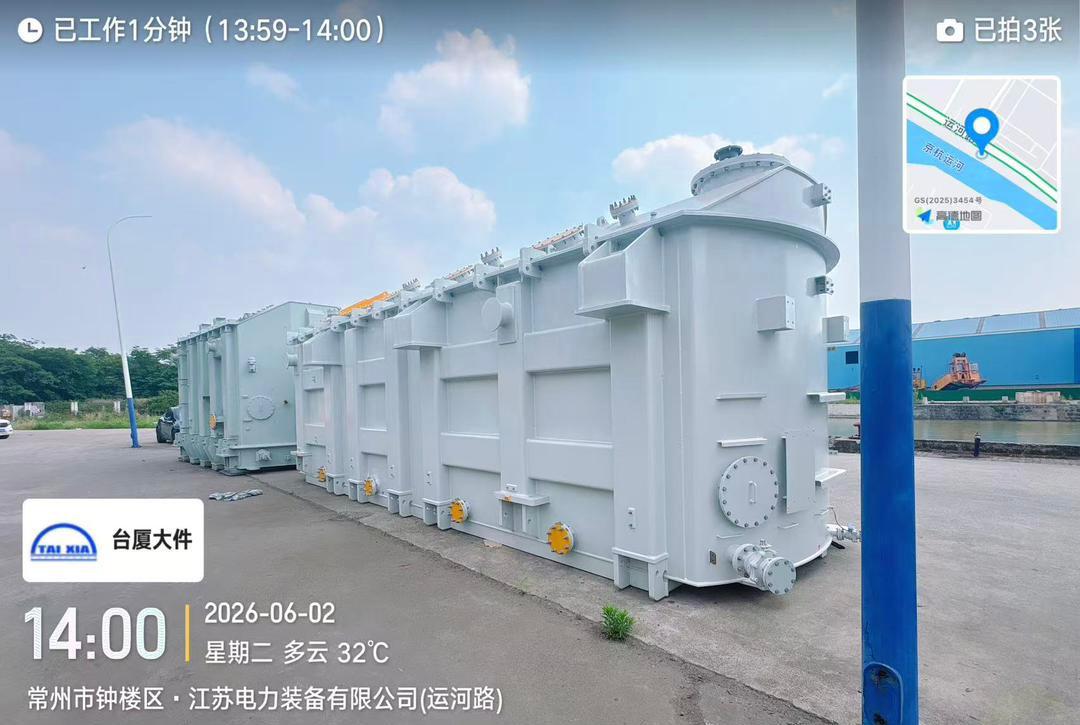

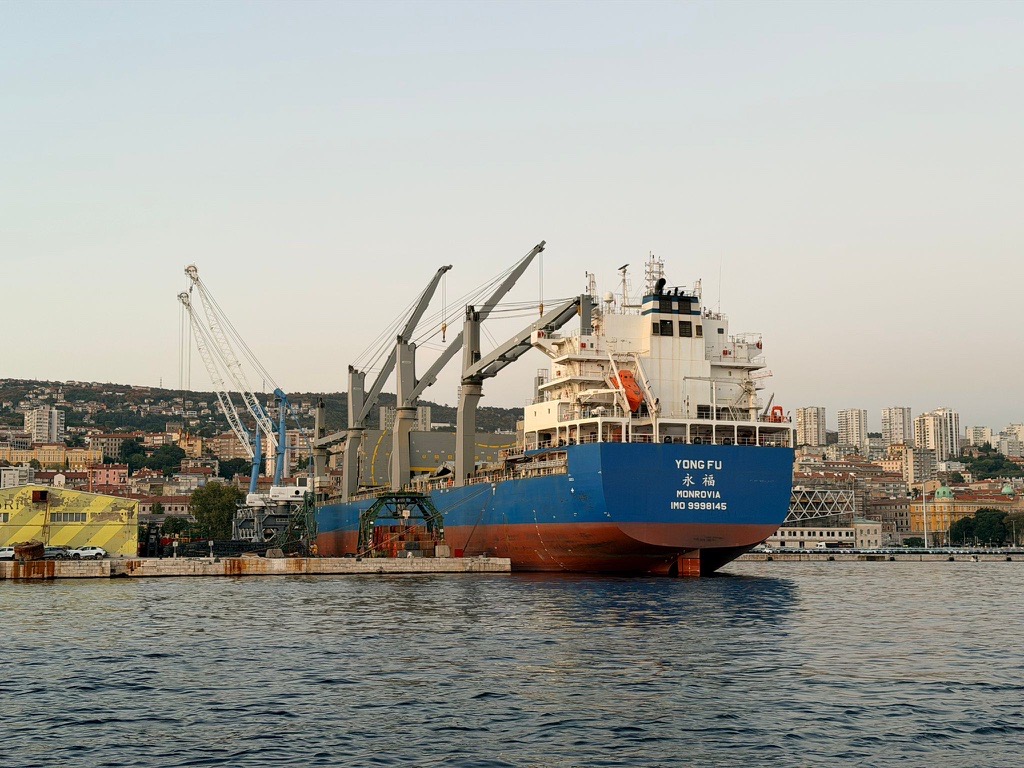

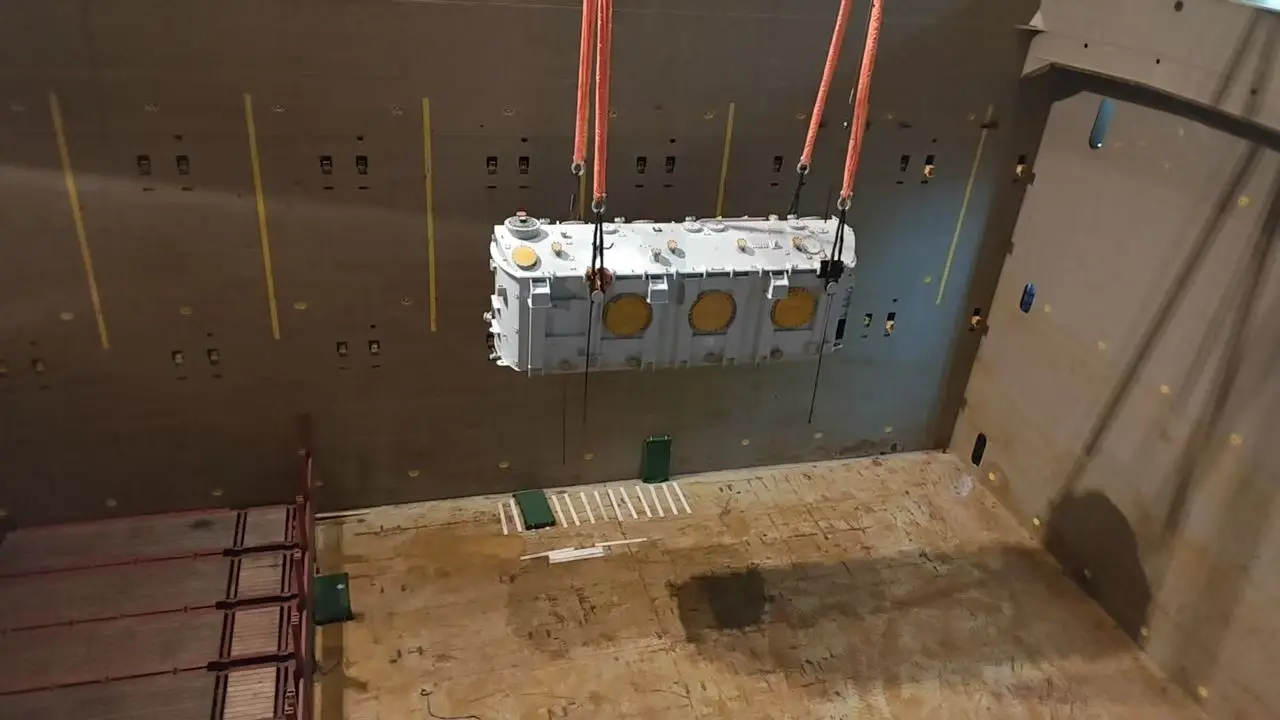

Factory Acceptance Test of the transformer
Before being transported to the Czech Republic, the transformer is thoroughly inspected at the manufacturer’s facility. The Factory Acceptance Test ensures that the technical requirements are met and that the system is ready for delivery.
